Schedule Optimization

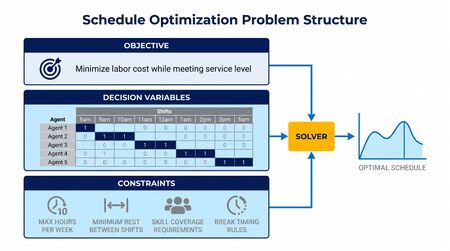

Schedule Optimization is the mathematical optimization layer beneath schedule generation[1]. Schedule generation is the method — assign agents to shifts to satisfy demand. Schedule optimization is the math toolbox that solves the assignment: integer programming, mixed-integer programming, column generation, branch-and-price, and the metaheuristics that handle problem instances exact methods can't crack. Practitioners care about the toolbox because the choice of method determines which problems are solvable in production, what trade-offs the optimizer makes silently, and where the optimizer will fail when constraints intensify.
The literature is large and mature. Set-covering and set-partitioning formulations of shift scheduling go back to Dantzig (1954). Column generation for crew scheduling was developed in the 1960s and matured through the 1980s. Modern WFM software wraps these techniques in a configuration-and-rule layer; the optimization core is operations research at industrial scale.
What practitioners build
A schedule optimization stack inside a WFM operation comprises four layers, each consuming the layer below:
- Problem formulation layer — translates the business problem (coverage requirements, agent constraints, organizational rules) into mathematical structure (variables, constraints, objective function). This is where most operational quality is determined; a poorly formulated problem cannot be rescued by a better solver.
- Solver layer — the algorithmic engine that produces a feasible (and ideally optimal) solution. Commercial solvers (Gurobi, CPLEX, FICO Xpress) versus open-source (CBC, GLPK, HiGHS, OR-Tools); exact methods versus heuristics.
- Decomposition layer — for problems too large for monolithic solving, decomposition strategies (column generation, Benders decomposition, Lagrangian relaxation, time-window decomposition). Sophisticated WFM optimization for large operations is decomposition-heavy.
- Metaheuristic layer — when the exact methods can't finish in the available time window, metaheuristics (simulated annealing, tabu search, genetic algorithms, large neighborhood search) produce good-but-not-optimal solutions. Most production systems use a hybrid: exact for the core, metaheuristic for refinement or for specific sub-problems.
The practitioner's deliverable is not a method choice; it is a stack design. The stack must be appropriate to the operation's scale, constraint complexity, optimization-window length, and tolerance for sub-optimality.
Method families
Integer Programming (IP) and Mixed-Integer Programming (MIP)
The default formulation. Variables are binary (assign-or-not) or mixed binary-and-continuous. The model is solved via branch-and-bound or branch-and-cut. Modern commercial MIP solvers handle WFM-scale problems (thousands of agents, hundreds of shifts, weekly horizon) routinely.
When IP/MIP wins:
- The problem fits in a single solve (typically up to about 100,000 binary variables for hard variants, more for easier structure)
- Optimality matters more than speed
- Constraints are well-structured (set covering, set partitioning, transportation-like)
When IP/MIP loses:
- Scale exceeds single-solve capacity
- The shift catalog is implicit or combinatorially large
- The problem must re-solve every few minutes (real-time adjustment)
Standard formulation: see the set-covering and assignment formulations on Schedule Generation and Rostering.
Column Generation
For problems where the shift catalog is implicit or astronomical (continuous shift start times, very flexible break placements, very long planning horizons), enumerating all possible shifts as variables is infeasible. Column generation decomposes the problem:
- Master problem — a restricted version of the IP with only a subset of shifts (columns)
- Pricing subproblem — given the LP duals from the master, identify shifts that would improve the objective if added
- Iteration — add improving shifts; re-solve master; repeat until no improving shift exists
Column generation produces the LP relaxation; recovering integer solutions requires branch-and-price (column generation embedded inside branch-and-bound). The combination is the dominant method for highly flexible shift catalogs and is the basis of what most enterprise WFM platforms call "advanced scheduling."
When column generation wins:
- Shift catalogs with continuous or near-continuous variation
- Long planning horizons where shift patterns repeat
- Very large operations where the explicit IP formulation is too large
When column generation loses:
- Small operations where the explicit IP solves directly
- Pricing subproblem itself is hard (then you're stacking complexity without benefit)
Benders Decomposition
Decomposes a problem into a master problem and one-or-more subproblems. Used in WFM when the schedule and the routing or break-placement must be co-optimized; the master sets the schedule structure, the subproblem evaluates the resulting routing or break placement. Less common than column generation in classical WFM but increasingly applied in joint schedule-routing optimization (cross-link to Multi-Skill Scheduling).
Constraint Programming (CP)
A different paradigm: declare variables and the constraints among them; the solver propagates constraints and searches the resulting feasible region. CP excels when constraints are highly structured (rest periods, consecutive-day rules, mandatory pattern constraints). It is weaker than IP at proving optimality but often faster at finding any feasible solution.
Modern hybrid solvers (CP-SAT in Google OR-Tools is a notable example) combine CP propagation with SAT-style search and IP-style cuts; on rostering and scheduling problems they often outperform pure IP.
Metaheuristics
When exact methods don't finish within the optimization window, metaheuristics produce good solutions quickly. The major families:
- Simulated annealing — accept locally-suboptimal moves with probability that decreases over time; escapes local optima. Good for highly constrained problems with smooth objective surfaces.
- Tabu search — maintain a list of recently-explored moves and avoid re-exploring; good for discrete, highly structured problems. Many production WFM systems use tabu-search variants for refinement.
- Genetic algorithms — evolve a population of candidate schedules through crossover and mutation; useful when the problem has multiple soft preferences and the objective surface is rough.
- Large Neighborhood Search (LNS) — destroy part of a feasible solution, repair with a focused optimization; very effective on rostering and scheduling problems and is the dominant metaheuristic in modern academic literature.
The metaheuristic choice often matters less than the operational discipline around it: how is the initial solution constructed, when does the search terminate, how is the result validated against the optimal-or-near-optimal benchmark.
Choosing among methods: the operational decision
For a WFM team designing or evaluating a schedule optimization stack, the decision tree:
- Is the problem small enough that monolithic IP solves in the available window? (Available window: typically 30 minutes for weekly batch, 30 seconds for intraday adjustment.) If yes, use IP. Most operations under 200 agents fall here for weekly batch.
- Is the shift catalog explicit and bounded? If yes, IP is still likely the right choice. Large agent pools with bounded shift catalogs solve in IP at scales up to a few thousand agents per solve.
- Is the shift catalog implicit, continuous, or combinatorially large? Use column generation / branch-and-price. This is the regime most large enterprise operations operate in.
- Does the optimization need to co-determine schedule and routing (or schedule and break placement)? Use Benders decomposition or joint optimization with explicit decomposition structure.
- Does the optimization run in real-time (sub-minute response)? Use a metaheuristic warm-started from the previous solution. Cross-link to Real-Time Schedule Adjustment.
- Does the optimization have many soft preferences with no clear objective hierarchy? Consider multi-objective approaches; cross-link to Multi-Objective Optimization in Contact Center.
The competent practice is rarely a single method. Most production stacks combine: IP for the core, column generation when the catalog grows, metaheuristic for refinement and real-time, CP for highly-constrained sub-problems.
Tools and solver landscape
Commercial solvers:
- Gurobi — current performance leader for MIP across industries; standard in enterprise WFM that does its own optimization
- IBM CPLEX — mature, capable, extensive library; common in legacy enterprise stacks
- FICO Xpress — strong on column generation and decomposition
Open-source solvers:
- Google OR-Tools — particularly the CP-SAT solver; competitive with commercial solvers on many WFM-shaped problems; widely used as the entry point for organizations building optimization in-house
- Pyomo — Python modeling layer that targets multiple solvers (including commercial)
- JuMP (Julia) — modeling layer with strong column-generation and decomposition support
- HiGHS — modern open-source LP/MIP solver, increasingly competitive
- CBC (COIN-OR) — mature open-source MIP solver
Enterprise WFM platforms that wrap these techniques:
- NICE IEX — long-standing scheduling engine with proprietary heuristic-and-IP hybrid
- Verint — heuristic-and-IP hybrid; strong on rule configuration
- Calabrio — IP with metaheuristic refinement
- Alvaria (formerly Aspect) — historical strength in column generation
- Genesys — modern stack; column generation for the advanced scheduling tier
The platform vendors do not generally publish the optimization architecture. Practitioners evaluating platforms should ask: how does the optimizer scale, what is the optimality gap reported on test problems, what is the failure mode when the solver times out (best feasible? prior schedule? error?). Vendors that cannot answer these questions are running heuristics that aren't documented.
Common failure modes
- Optimizing the wrong objective. The model minimizes labor cost; the operational reality penalizes service level shortfall more heavily than over-staffing. The optimizer produces "optimal" schedules that fail the operation. The fix is in formulation, not solver tuning.
- Ignoring integrality gaps. The LP relaxation gives a lower bound; the integer solution gives an upper bound; the gap measures how confident you can be in the integer solution's optimality. Practitioners who don't track the gap don't know whether the optimizer found a near-optimal solution or a mediocre feasible solution.
- Single-solve thinking on multi-period problems. Schedules generated independently for week 1 and week 2 often produce contradictions at the boundary (an agent's last shift week 1 is too close to their first shift week 2 to satisfy rest constraints). The fix is rolling-horizon optimization or explicit boundary constraints.
- Trusting metaheuristics blindly. "The genetic algorithm produces a schedule" — fine, but is the schedule near-optimal or 30% worse than what a real solver would produce? Without a benchmark, you're guessing.
- Solver-as-magic. Throwing the problem at a commercial solver and accepting the output. Modern solvers are powerful but not omniscient; problem formulation, constraint modeling, and pre-processing all matter. The optimizer is a collaborator, not an oracle.
- Not checking the dual. For problems where coverage is binding and labor cost matters, the LP duals identify which intervals are "expensive" — i.e., where one more agent of supply would yield the most cost reduction. WFM teams that don't read the duals miss the most-actionable intelligence the solver produces.
- Stale formulation. Constraints change. Labor laws update; contracts get renegotiated; demand patterns shift. The formulation that solved last year's problem may produce sub-optimal or infeasible solutions today.
Maturity Model Position
In the WFM Labs Maturity Model™, schedule optimization practice progresses from rule-based or single-pass heuristic scheduling to integrated multi-method optimization with explicit benchmarking:
- Level 1 — Initial (Emerging Operations) — schedules built manually in spreadsheets or basic templates; no optimization; coverage failures attributed to forecasting error.
- Level 2 — Foundational (Traditional WFM Excellence) — WFM software's default scheduling engine in use; usually a heuristic-IP hybrid; optimization runs as a black box; the operations team configures rules but does not understand or evaluate the optimization core; integrality gap not tracked; objective function reflects vendor defaults rather than organizational priorities.
- Level 3 — Progressive (Breaking the Monolith) — explicit understanding of the optimization stack; objective function tuned to organizational priorities; integrality gap tracked and reported; column generation deployed where the shift catalog warrants; benchmark comparisons run periodically (in-house IP versus vendor output, exact versus heuristic); WFM team can articulate trade-offs.
- Level 4 — Advanced (The Ecosystem Emerges) — joint optimization across schedule, routing, and break placement; rolling-horizon optimization across planning periods; integrated metaheuristic-and-exact stack with explicit warm-starting; pool-aware optimization differentiated for Pool AA, Pool Collab, and Pool TLM; LP duals consumed as scheduling intelligence (where to invest in additional capacity, which constraints to relax, which skills to cross-train).
- Level 5 — Pioneering (Enterprise-Wide Intelligence) — schedule optimization is part of an integrated supply-demand orchestration layer; continuous re-optimization with model-predictive control; the optimizer is a first-class participant in capacity-planning, hiring, and skill-investment decisions; the math is open to inspection and challenge by the WFM team and the operations leadership.
The cluster's pivotal lift is from Level 2 to Level 3 — moving from "the optimizer is what the vendor ships" to "the optimization is something we understand, tune, and evaluate." Most operations that complain about schedule quality are running Level 2 optimization with Level 3 expectations.
References
- Koole, G. Call Center Optimization. MG Books, 2013. Chapters 7-8 cover the standard formulations and methods; primary source for this page.
- Caprara, A., Toth, P., & Fischetti, M. "Algorithms for the set covering problem." Annals of Operations Research 98(1), 2000. Reference treatment of set-covering algorithms underlying schedule generation.
- Dantzig, G. B. "A comment on Edie's traffic delay at toll booths." Operations Research 2(3), 1954. The classical formulation of the shift scheduling problem as a set-covering integer program.
- Beasley, J. E. "OR-Library: distributing test problems by electronic mail." Journal of the Operational Research Society 41(11), 1990. Source of the standard test problems used to benchmark scheduling algorithms.
- Ernst, A. T., Jiang, H., Krishnamoorthy, M., & Sier, D. "Staff scheduling and rostering: A review of applications, methods and models." European Journal of Operational Research 153(1), 2004. Comprehensive method survey.
- Wolsey, L. A. Integer Programming. Wiley, 1998 (2nd ed. 2020). Standard textbook on IP methods.
- Desrosiers, J., & Lübbecke, M. E. "A primer in column generation." In Column Generation (Springer, 2005). Standard reference on column generation.
Tools
- Erlang Suite — supplies the demand inputs the optimizer minimizes coverage shortfall against; Day Planner produces interval-level demand profiles.
- Staffing Gap Optimizer — applies multi-objective optimization to the staffing-gap-fill problem (overtime versus temp); demonstrates the Pareto-frontier reasoning that schedule optimization formalizes.
- Google OR-Tools — open-source CP-SAT solver and MIP layer; competitive with commercial solvers for many WFM-shaped problems; entry point for in-house optimization.
- Gurobi, IBM CPLEX, FICO Xpress — commercial MIP solvers; performance leaders at scale.
See Also
- Scheduling Methods — overview of the scheduling cluster
- Schedule Generation — the method that schedule optimization solves
- Rostering — the bipartite assignment problem schedule optimization extends to named employees
- Multi-Skill Scheduling — coupling of schedule and routing in the optimization
- Break Optimization — within-shift placement problem solved with the same toolbox
- Multi-Objective Optimization in Contact Center — multi-objective formulations and Pareto frontiers
- Probabilistic Scheduling — distributional approach to demand inputs
- Discrete-Event vs. Monte Carlo Simulation Models — simulation methods that complement and validate optimization
- Real-Time Schedule Adjustment — fast metaheuristic re-optimization in production
- Capacity Planning Methods — capacity inputs to optimization
- Schedule Quality Metrics — benchmarking metrics for evaluating optimizer output
- Schedule Maintenance — re-optimization triggered by approved leave or coverage shifts
See Also
- ↑ Koole, G. (2013). "Call Center Mathematics". MG Books.
