Schedule Maintenance

From WFM Labs

Schedule Maintenance is the operating discipline that keeps schedules current between generation cycles: handling time-off requests, overtime, voluntary time off (VTO), shift swaps, exceptions, and the steady stream of changes that arrive after a schedule is published but before it is operationalized. It is the cadence layer between schedule generation and real-time adjustment — neither full re-optimization nor intraday correction.

For practitioners, the importance is operational. The schedule generated last Friday is rarely the schedule that runs on Wednesday. Time-off requests arrive, agents call out, training gets rescheduled, contract changes hit. Without disciplined schedule maintenance, the published schedule and the operating reality diverge silently — and the divergence shows up as adherence problems, coverage gaps, and missed forecasts that look like other kinds of failure.

The operating cadence

A practitioner's mental model of the schedule lifecycle:

  1. Build — schedule generation produces the schedule for a planning period (typically one week or two).
  2. Publish — the schedule is released to agents with sufficient notice (commonly 7-14 days, sometimes longer per labor agreement).
  3. Adjust — schedule maintenance handles time-off, swaps, OT, VTO, exceptions during the lead-time-to-operations window. Real-time schedule adjustment handles intraday changes.
  4. Operate — the schedule runs; adherence is measured.
  5. Archive — the realized schedule and its variance from the published version are stored. Inputs to the next cycle and to Variance Harvesting analysis.

Schedule maintenance owns the third step. It is the mechanism by which the published plan accommodates the world as it actually develops without forcing a full schedule regeneration.

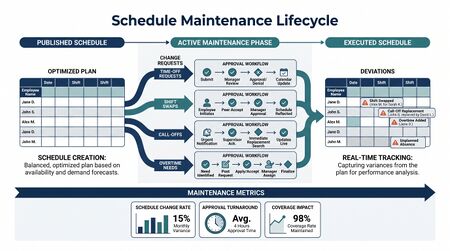

The build-publish-adjust-archive lifecycle

A more detailed view of the lifecycle and where maintenance sits:

Phase Trigger Owner Time horizon
Build Weekly cycle (or longer) Scheduler Multi-day batch
Publish Build complete WFM Within hours of build
Maintain Time-off, swaps, OT, VTO WFM + Operations From publish to start of day
Adjust Intraday variance RTA team During operations
Archive End of period WFM Post-period

The boundary between maintain and adjust matters: maintenance has time to plan and approve; adjustment must execute in minutes. The same lever (calling overtime) becomes a different operation depending on which phase invokes it. A maintenance OT is planned 3 days ahead with full notice; an adjustment OT is called for the next 4 hours. The systems for each should be designed accordingly.

What schedule maintenance handles

The standard event types:

Time-off requests

Most labor agreements require organizations to honor time-off requests with reasonable notice. The maintenance system needs:

  • Request capture — usually self-service through agent portal
  • Approval logic — based on coverage analysis, seniority rules, fairness queues
  • Schedule update — replace the affected agent's shift with PTO; backfill if coverage drops below threshold
  • Audit trail — who requested, who approved, what coverage analysis showed

A common Level 2 failure: requests are approved without coverage analysis, then real-time adjustment is left to fix the gap. Maintenance and adjustment are doing each other's job.

Shift swaps

Agents trade shifts with each other within the published schedule. Two patterns:

  • Direct swap — Agent A and Agent B exchange shifts on agreed dates
  • Open shift posting — Agent A posts their shift; any qualified agent can claim it

Modern WFM software supports both patterns. The maintenance discipline is verification: do both agents have the right skills for the swapped shift? Are regulatory constraints (rest periods, weekly hours) still satisfied? Does the swap create a coverage problem the optimizer would not have allowed?

Overtime offers

Planned overtime — the operation expects to need additional hours and offers OT to existing staff in advance. Distinct from real-time emergency OT. The maintenance discipline:

  • Identify the coverage gap from the schedule + forecast
  • Compute the OT requirement
  • Distribute the offer per fairness rules (seniority, prior OT distribution, opt-in lists)
  • Update the schedule with accepted OT

Voluntary time off (VTO)

The mirror of overtime. The operation expects to be over-staffed and offers agents the option to take unpaid time off. VTO is high-leverage when offered against probabilistic forecasts: forecast a P10 demand at certain intervals, offer VTO covering the gap from P50 down to P10, accept agent take-up, capture the cost saving.

Exceptions and one-off changes

Training that runs longer than scheduled. Coaching sessions added at supervisor request. Project work pulling agents off-phone for specific intervals. Each becomes a maintenance event: the schedule is modified to reflect the exception with proper documentation and impact analysis.

Schedule version control

A discipline most WFM teams underuse. The published schedule is version 1; every maintenance change is a new version. Best-practice systems keep the version history accessible and comparable. Why this matters:

  • Adherence measurement reference — adherence at 2:00 PM should be measured against the schedule version active at 2:00 PM, not the originally published schedule. A change made at 10:00 AM means the original schedule is no longer authoritative.
  • Variance attribution — when a coverage gap appears, was it the original schedule's failure, a maintenance event's failure, or operations? Version control lets the analysis distinguish.
  • Contract compliance — labor agreements often constrain schedule changes (notice requirements, change limits). Without version history, compliance cannot be audited.
  • Maintenance learning — patterns in what gets changed signal where the schedule generation can be improved next cycle.

Most enterprise WFM software supports version tracking; few WFM teams use it deliberately. Building the discipline is high-leverage, low-cost.

The off-phone budget connection

Shift Design establishes the principle: off-phone time should be a pooled budget rather than a fixed assignment. Schedule maintenance is the layer that delivers on that principle for events with lead time:

  • Coaching scheduled this week → moved to a different interval next week based on coverage and learning needs
  • Training cohort planned for Tuesday → moved to Thursday because Tuesday demand surged
  • Team meeting scheduled for 2:00 PM → moved to 11:00 AM because the demand trough is at 11:00 AM

These are maintenance changes, not real-time adjustments — they have hours or days of lead time. The maintenance system must support the moves with the same discipline as time-off and OT.

The contrast: organizations that do not pool off-phone time treat each coaching slot as a contract that must be honored at exactly the published time. Schedule maintenance becomes a compliance burden rather than an optimization lever.

Common failure modes

  • Approving without coverage analysis. The fastest path to time-off chaos. Approval requires checking the resulting coverage, not just the agent's request.
  • No fairness queue. Time-off, OT, and VTO all need fairness disciplines. Agents who are quick at requesting get all the time-off; agents who happen to need consecutive days don't. A simple seniority + prior-grant tracking discipline solves this.
  • Maintenance changes invalidating adherence measurement. Adherence measured against the original schedule when maintenance has updated the schedule produces nonsense. The version-control discipline prevents this.
  • Treating maintenance as overhead. Maintenance volume signals system health. High maintenance volume usually indicates either bad schedule generation (the schedule didn't reflect reality) or operational instability (lots of last-minute changes). Diagnose, don't just process.
  • Not capturing maintenance data. What gets changed, how often, by whom — this is signal for the next forecast cycle and the next schedule design. Without capture, the lift cannot be made.
  • Ignoring pool structure. Time-off and OT in Pool TLM (mastery work) operate on different time horizons and fairness rules than Pool AA (high-volume frontline). One-size-fits-all maintenance rules produce wrong-shape outcomes.
  • No coverage forecast on maintenance decisions. Approving an OT request without checking whether the demand is actually likely to materialize wastes labor cost. Approving a VTO without checking whether forecast variance might bring demand back wastes service level. Maintenance decisions deserve the same forecasting rigor as the original schedule.

What practitioners build

Building a competent schedule maintenance practice:

  1. Define the event types. Time-off, swap, OT offer, VTO offer, exception. Each gets a process, an approval criterion, and a system path.
  2. Set the lead-time boundaries. At what notice does a request become a maintenance event vs. a real-time adjustment? Standard: anything within 24 hours of operation is real-time; beyond that is maintenance.
  3. Build the coverage-impact tooling. Every maintenance request runs through an automated coverage analysis. Approval is conditional on the resulting coverage being acceptable (at P50, P80, or whatever standard the operation uses).
  4. Establish fairness queues. Track who got OT, who took VTO, who had time-off granted. Use the data to distribute future requests fairly.
  5. Implement version control. Every change creates a new schedule version. Adherence and analysis pull the right version automatically.
  6. Differentiate by pool. Pool AA, Pool Collab, Pool TLM each have different maintenance patterns. Encode the differences.
  7. Capture and analyze. Maintenance events become data. Data informs forecasting and schedule generation.

Implementation sequence

Order of work for a WFM team building this from scratch:

  1. Document current maintenance volume by event type. Most teams find more events than they expected.
  2. Implement coverage-impact tooling — automated analysis of any proposed change. Eliminate the most common failure (approval without analysis).
  3. Add version control. The hooks usually exist in the WFM software; most teams just don't use them.
  4. Add fairness queues — seniority lists, prior-grant tracking, opt-in / opt-out registers.
  5. Differentiate the maintenance rules by pool and by event lead time.
  6. Build the analytics layer — what gets changed, why, with what impact.
  7. Move toward a self-service maintenance portal where most events are agent-initiated within rules, with automated approval and human review only for exceptions.

Maturity tells

  • Level 2 — maintenance is reactive, mostly manual, performed by a person reading email and updating the schedule by hand. No coverage analysis on requests. No version control. Adherence measured against the originally published schedule even when changes have been made.
  • Level 3 — coverage-impact tooling, fairness queues, documented event types, version control. Self-service for most events. Capture-and-analyze in place.
  • Level 4 — automated maintenance for most event types; pool-aware logic; integrated with Variance Harvesting practice; off-phone budget delivered as a maintenance lever rather than a fixed assignment.
  • Level 5 — maintenance is part of continuous schedule optimization; the build-maintain-adjust boundary dissolves; the workforce-supply layer responds continuously to the demand layer with maintenance as the named lead-time mechanism.

Maturity Model Position

In the WFM Labs Maturity Model™, schedule maintenance is the lead-time-to-operations layer — distinct from generation (multi-day batch) and from real-time adjustment (within-day). Most organizations treat maintenance as an afterthought; treating it as a discipline is one of the more measurable Level 2 → Level 3 lifts.

  • Level 1 — Initial (Emerging Operations) — maintenance is informal, manual, ad-hoc; no documented process; coverage gaps from changes are absorbed silently.
  • Level 2 — Foundational (Traditional WFM Excellence) — manual maintenance handled by WFM analysts via email or chat; approval without coverage analysis; no version control; no fairness queues.
  • Level 3 — Progressive (Breaking the Monolith) — coverage-impact tooling, version control, fairness queues, documented event types; off-phone time is a pooled budget delivered as a maintenance lever.
  • Level 4 — Advanced (The Ecosystem Emerges) — automated maintenance for routine events; pool-aware rules from the Three-Pool Architecture; integration with Variance Harvesting and Real-Time Schedule Adjustment; maintenance data feeds the next generation cycle.
  • Level 5 — Pioneering (Enterprise-Wide Intelligence) — continuous schedule optimization; the build-maintain-adjust phases blur into one ongoing process; maintenance is part of the supply-and-demand orchestration layer.

The discipline of treating maintenance as its own thing — not generation, not adjustment — is itself a maturity tell. Organizations that conflate them tend to fix maintenance problems by re-running generation (expensive, disruptive) or by leaving them to real-time adjustment (too late, too lossy).

References

  • Koole, G. Call Center Optimization. MG Books, 2013. Open-access; the canonical contact-center text. Coverage of scheduling lifecycle is foundational here.
  • Cleveland, B. Call Center Management on Fast Forward (3rd ed.). ICMI Press, 2012. Practitioner treatment of the WFM operating cadence including maintenance.
  • Reynolds, P. Call Center Workforce Management. Call Center School Press. Practitioner-focused on the operating model.
  • Pinedo, M. L. Scheduling: Theory, Algorithms, and Systems (6th ed.). Springer, 2022. General scheduling theory including the rolling-horizon and re-optimization frames.
