WFM Processes

From WFM Labs

WFM Processes defines the operational process architecture that translates workforce management strategy into daily execution. Every WFM output — forecasts, schedules, real-time decisions — is the product of a process. When those processes are well-designed, WFM operates as an integrated system. When they're ad hoc, WFM devolves into disconnected activities that happen to share a department name.

Overview

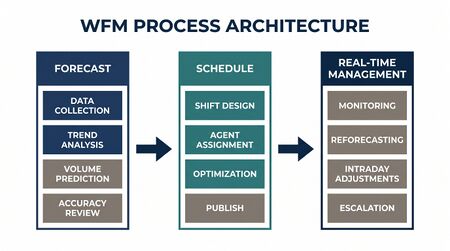

Three-pillar WFM process architecture

The WFM process architecture rests on three pillars: Forecasting, Scheduling, and Real-Time Operations. These are not independent activities — they form a sequential dependency chain where each pillar's output feeds the next. Forecast accuracy determines schedule quality. Schedule quality determines real-time effectiveness. And real-time performance data feeds back into forecast improvement.

Most WFM process failures originate not within a pillar but at the handoff between them. The forecast is accurate but the scheduler doesn't use the latest version. The schedule is optimized but real-time doesn't have authority to make adjustments. The RTA documents intraday variance but no one feeds it back into the forecast model. Fixing WFM processes means fixing these connections as much as fixing the activities themselves.

The Three-Pillar Process Architecture

Pillar Primary Question Inputs Outputs Owner
Forecasting "How much work will arrive and how long will it take?" Historical data, business events, growth trends, AI deflection rates Volume and AHT predictions by interval, channel, and skill group Forecaster
Scheduling "How do we staff to meet demand within constraints?" Forecast, agent availability, labor rules, goals, shrinkage assumptions Agent schedules, coverage reports, efficiency metrics Scheduler
Real-Time Operations "Are we on track, and what do we adjust?" Schedule, live queue data, agent states, intraday forecast Intraday adjustments, variance documentation, performance reports Real-Time Analyst

The Dependency Chain

The three pillars are not parallel workstreams — they are sequential dependencies with feedback loops:

Forward flow: Forecast → drives staffing requirements → drives schedule construction → drives real-time execution baseline.

Feedback flow: Real-time variance → informs forecast model recalibration → informs shrinkage assumption updates → informs schedule parameter adjustments.

The critical implication: A 5% forecast error doesn't stay a 5% problem. It cascades through scheduling (wrong staffing levels) into real-time (constant firefighting) and eventually into goal attainment (missed service levels or inflated costs). Process quality compounds — in both directions.

The Planning Cycle

WFM processes operate across multiple time horizons simultaneously. Each horizon has distinct activities, owners, inputs, and review cadences.

Horizon Timeframe Primary Activities Key Decisions Review Cadence
Annual 12–18 months Capacity planning, budget development, headcount authorization FTE allocation by quarter, technology investments, organizational structure Annual with quarterly checkpoints
Quarterly 3–6 months Hiring plan refinement, training pipeline scheduling, seasonal preparation Net hire targets, training class schedules, vendor staffing levels Monthly review, quarterly reset
Monthly 4–8 weeks Volume forecast finalization, schedule template design, shrinkage calibration Shift patterns, overtime budget, time-off quotas Bi-weekly review
Weekly 1–2 weeks Agent schedule publication, final forecast lock, pre-week briefing Specific agent assignments, coverage adjustments, known event preparation Weekly review (typically Monday or Friday)
Daily Next 24 hours Day-of forecast update, absence processing, micro-adjustments Overtime calls, VTO offers, skill reassignments Start-of-day and mid-day checkpoints
Intraday Current interval through end-of-day Real-time monitoring, interval-by-interval adjustment Break moves, skill changes, queue priority adjustments, escalations Continuous (every 15–30 minutes)

The planning paradox: Longer horizons have more uncertainty but require bigger decisions (hiring takes months). Shorter horizons have more certainty but only allow smaller adjustments (you can move a break but can't hire an agent intraday). Effective WFM processes accept this paradox and design decision gates that match decision magnitude to information quality.

Process Inputs and Outputs

Forecasting Process

Input Source Criticality
Historical contact volume (interval-level) ACD / WFM platform Critical — foundation of all statistical forecasting
Historical AHT by skill group ACD / WFM platform Critical — drives staffing requirement calculations
Business event calendar Marketing, product, operations High — explains non-pattern variance
Growth/decline projections Finance, sales, business planning High — adjusts baseline for volume trends
AI deflection rates and trends AI/automation platform Increasing — fundamentally changes human demand forecasting
Channel migration data Digital platform analytics Medium — shifts volume between forecast models

Outputs: Interval-level volume and AHT forecasts by channel, skill group, and planning horizon. Confidence intervals for each forecast. Documented assumptions and event overlays.

Scheduling Process

Input Source Criticality
Forecast (volume + AHT by interval) Forecasting process Critical — determines required staffing levels
Agent roster (skills, availability, contracts) HRIS / WFM platform Critical — defines the supply side of the equation
Shrinkage assumptions Historical analysis High — incorrect shrinkage assumptions are the #1 cause of understaffing
Labor rules and regulations Legal / HR / union contracts High — constraints that override optimization
Agent preferences and requests WFM platform / request system Medium — affects schedule quality and employee experience goals
Goal parameters WFM leadership High — defines what "optimized" means

Outputs: Published agent schedules. Coverage reports by interval showing forecast vs. scheduled staff. Efficiency metrics (schedule efficiency, overstaffing/understaffing analysis). Time-off approval/denial decisions.

Real-Time Operations Process

Input Source Criticality
Published schedule Scheduling process Critical — the baseline for variance detection
Live queue data (calls in queue, SL, ASA) ACD real-time feed Critical — the primary signal stream
Agent state data (available, AUX, ACW) ACD / WFM platform Critical — determines actual vs. planned staffing
Intraday forecast update Forecasting process (if available) High — recalibrates expectations based on developing patterns
Playbook / escalation protocols WFM leadership High — pre-defined response actions
Communication channels to supervisors Chat, phone, radio Medium — execution depends on real-time coordination

Outputs: Intraday adjustment actions (documented). Variance reports (planned vs. actual by interval). End-of-day performance summary. Event logs for post-day analysis and forecast feedback.

Process Ownership and RACI

Clear process ownership prevents the "everyone's responsible so no one is" failure mode. The following RACI framework applies to a mature (Level 3+) WFM function.

Process Activity Forecaster Scheduler RTA Capacity Planner WFM Manager
Long-range capacity forecast C I R/A A
Short-range volume forecast R/A I I C A
Shrinkage analysis and calibration C R C I A
Schedule generation I R/A I A
Schedule publication and communication I R I A
Intraday monitoring and adjustment I C R/A A
Post-day variance analysis R C R I A
Forecast model evaluation and selection R/A C A
Goal framework and target-setting C C C C R/A

R = Responsible (does the work), A = Accountable (owns the outcome), C = Consulted, I = Informed

Process Maturity

WFM process maturity follows a progression from ad hoc execution to autonomous operation. Each level builds on the previous one — skipping levels creates fragile capability that collapses under stress.

Level Process State Characteristics Typical Indicators
1 — Manual Ad hoc, person-dependent Processes exist in one person's head. No documentation. Output quality depends entirely on who's working. Spreadsheet-based forecasting. Manual schedule building. No formal real-time process.
2 — Standardized Documented and repeatable Written procedures exist. Multiple people can execute. Consistent output regardless of who's working. Documented forecast methodology. Standard schedule templates. RTA playbook exists.
3 — Integrated Cross-process coordination Handoffs between forecasting, scheduling, and real-time are formalized. Feedback loops exist and are used. Automated forecast-to-schedule feed. Structured post-day review drives forecast updates. Shrinkage tracked and recalibrated monthly.
4 — Optimized Data-driven continuous improvement Processes are measured, analyzed, and systematically improved. Optimization happens at the process level, not just the output level. Process cycle time tracked. A/B testing of forecast methods. Schedule optimization algorithms tuned quarterly. RTA response time measured.
5 — Autonomous AI-augmented with human governance Routine process execution is automated. Humans manage exceptions, set governance boundaries, and handle novel situations. Auto-generated forecasts with human approval gates. AI-optimized schedules with constraint overrides. Automated real-time micro-adjustments within defined bounds.

Cross-Process Dependencies

The most impactful WFM improvements often come from fixing the connections between processes rather than optimizing individual processes.

Forecast → Schedule

Healthy state: Forecaster publishes updated forecast. Scheduler automatically receives it in the WFM platform. Schedule regeneration uses latest forecast. Discrepancies between forecast versions are flagged.

Common failure: Scheduler uses last week's forecast because "it's close enough" or because the platform doesn't auto-update. Every hour of delay between forecast publication and schedule generation introduces drift.

Fix: Automate the forecast-to-schedule handoff. Establish a "forecast lock" deadline after which the scheduler works from a fixed version, with documented handling for late forecast changes.

Schedule → Real-Time

Healthy state: Published schedule is the RTA's baseline. Variance from schedule is immediately visible. RTA has pre-authorized adjustments for common scenarios.

Common failure: Schedule changes (swaps, time-off approvals) happen after publication but aren't reflected in the real-time baseline. RTA monitors against an outdated schedule and either misses real problems or chases phantom ones.

Fix: Single source of truth for the current schedule. All changes flow through the WFM platform. RTA dashboard reflects the current schedule, not the original schedule.

Real-Time → Forecast (Feedback Loop)

Healthy state: RTA documents intraday events (system outages, marketing surges, weather impacts) with timestamps, volume impact, and duration. Forecaster reviews event logs and adjusts historical data or model parameters. Patterns that recur become standard forecast inputs.

Common failure: RTA is too busy managing the moment to document what's happening. Post-day analysis doesn't happen because "tomorrow's already here." Forecaster lacks event context and treats anomalies as noise. The same surprise repeats monthly.

Fix: Structured event logging that takes <2 minutes per event. Weekly forecast-vs-actual review that explicitly reviews RTA event logs. This is Variance Harvesting — the systematic capture and exploitation of performance variance.

Process Measurement

How to know whether WFM processes are working, independent of whether WFM outcomes are meeting targets.

Process Health Metric Target Range What Deviation Signals
Forecasting Weekly WAPE (interval-level) < 5% for established queues Model degradation, unincorporated events, or structural change
Forecasting Bias (over/under direction) Within ± 2% Systematic model error that needs directional correction
Forecasting Forecast lock adherence > 95% of periods locked on time Process discipline breakdown
Scheduling Schedule efficiency > 92% Poor shift design or excessive constraints
Scheduling Coverage gap intervals < 5% of intervals understaffed by > 10% Insufficient FTEs or inflexible shift patterns
Scheduling Time from forecast lock to schedule publication < 48 hours (weekly) Process bottleneck or manual overhead
Real-Time Intraday adjustment response time < 15 minutes from trigger to action RTA understaffed, no playbook, or lack of authority
Real-Time Event documentation rate > 90% of significant events logged Process discipline breakdown
Cross-process Forecast-to-schedule version match 100% (scheduler uses latest forecast) Handoff failure
Cross-process Feedback loop completion rate > 80% of variance events reviewed within 7 days Broken feedback cycle

Technology Enablement

Each planning horizon and process pillar has different technology requirements. Mismatches between process maturity and technology capability create friction.

Process Stage Level 1–2 Technology Level 3–4 Technology Level 5 Technology
Forecasting Spreadsheets, basic WFM platform forecasting Advanced statistical modules, external data integration, automated model selection ML-driven forecasting with auto-retraining, multi-source data fusion, real-time forecast adjustment
Scheduling Manual schedule building in WFM platform Optimization engines with constraint modeling, automated shift generation AI-optimized scheduling with agent preference learning, dynamic re-optimization, multi-dimensional skill optimization
Real-Time Manual queue monitoring, phone/email to supervisors Real-time dashboards with alerts, automated VTO/OT notifications Autonomous micro-adjustments within governance bounds, predictive real-time (acting before the problem manifests)
Cross-Process Email and meetings Integrated WFM platform with automated handoffs Closed-loop automation: forecast → schedule → real-time → feedback → forecast with minimal human intervention

The technology trap: Organizations buy Level 4 technology and operate Level 2 processes. The platform has ML forecasting, but no one has configured it. The optimization engine exists, but schedulers override it because they "know better." Technology enables process maturity — it doesn't create it. Process discipline must lead technology adoption.

Common Failure Modes

Siloed Processes

Symptom: Forecasting, scheduling, and real-time operate as independent functions with minimal communication. Each optimizes its own output without understanding downstream impact.

Impact: Forecast accuracy is high but schedule quality is poor because the scheduler doesn't trust or use the forecast. Real-time performance is volatile because the RTA lacks schedule and forecast context.

Root cause: Organizational structure separates WFM functions. No cross-function meetings. No shared metrics. Often worsened by different reporting lines (forecasting reports to analytics, scheduling reports to operations).

Fix: Establish a weekly cross-function review. Create shared metrics that span pillars (e.g., "forecast-to-actual staffing gap" requires forecast AND schedule data). Ensure all WFM roles report to a single WFM leader.

Batch-Only Planning

Symptom: WFM operates on fixed cycles — weekly forecast, weekly schedule, no intraday reforecasting. The operation runs Monday's plan on Friday regardless of what's happened in between.

Impact: Slow response to changing conditions. Systematic over- or understaffing as the week progresses. Missed opportunities for efficiency gains (VTO when overstaffed, OT before crisis develops).

Root cause: Insufficient WFM staffing to support continuous planning. Technology limitations. Cultural resistance to "changing the plan."

Fix: Implement intraday reforecasting (even a simple mid-day check). Automate VTO/OT triggers based on real-time conditions. Build organizational acceptance that plans are hypotheses, not commitments.

No Feedback Loops

Symptom: The same forecast miss happens repeatedly. Shrinkage assumptions haven't been updated in a year. RTA insights never reach the forecaster.

Impact: WFM operates in open-loop mode — producing outputs without incorporating results. Performance stagnates or degrades despite experienced staff.

Root cause: No structured post-day or post-week review process. RTA too busy for documentation. Forecaster too busy producing next week's forecast to analyze last week's performance.

Fix: Mandate a weekly 30-minute cross-function review: What did we forecast? What happened? Why was there variance? What changes? This single meeting, done consistently, is the highest-ROI WFM process improvement available.

Over-Reliance on Heroic Individuals

Symptom: WFM processes work well when one specific person is present and fall apart during their absence. No documentation. No cross-training. All institutional knowledge is in one head.

Impact: Operational fragility. Key-person risk. Inability to scale or improve because the hero is too busy executing to document, delegate, or improve.

Root cause: The WFM function grew organically around a talented individual who never had time (or incentive) to formalize processes.

Fix: Document current-state processes. Cross-train at least one backup for every critical function. Measure process quality by how well it performs during the primary owner's absence — this is the true test.

Maturity Model Position

WFM Processes corresponds to the Process Maturity dimension of the WFM Labs Maturity Model™. Process maturity is assessed across:

  1. Documentation: None (L1) → complete standard operating procedures (L3) → living documents with automated compliance checks (L5)
  2. Integration: Siloed (L1) → formalized handoffs (L3) → closed-loop automation (L5)
  3. Measurement: No process metrics (L1) → output metrics tracked (L3) → process efficiency and cycle time optimized (L5)
  4. Feedback loops: None (L1) → structured weekly reviews (L3) → automated continuous learning (L5)
  5. Technology utilization: Below platform capability (L1) → platform fully utilized (L3) → AI-augmented with human governance (L5)

The gap between "we have WFM software" and "we have WFM processes" is where most maturity improvements begin. Software is a tool. Process is how you use it.
