Workforce Planning Calendar and Annual Planning Cycle

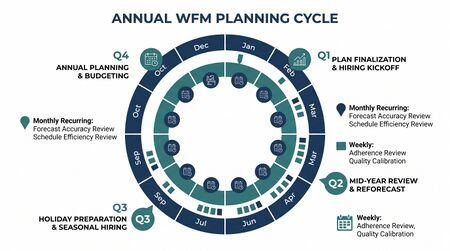

The workforce planning calendar is a structured annual schedule that coordinates all major workforce management activities across an organization, ensuring that long-range staffing models, budget submissions, schedule bid cycles, and peak-period plans are developed in the correct sequence and at the appropriate level of organizational authority. In contact center environments, the planning calendar transforms workforce management from a reactive, week-to-week discipline into a strategic function aligned with financial planning cycles, human resources timelines, and customer demand forecasts. A well-designed planning calendar reduces last-minute staffing crises, improves budget accuracy, and creates organizational predictability for both operations leaders and frontline agents.[1] The calendar is not a static document but a living operational framework that must be revisited each year based on changes in business volume, organizational structure, and technology capability.[2]
Principles of the Annual Planning Cycle
The annual planning cycle organizes workforce management work into four broad planning horizons: strategic (12–18 months), operational (3–12 months), tactical (2–8 weeks), and real-time (intraday). The workforce planning calendar primarily governs the strategic and operational horizons, establishing deadlines and ownership for activities that cascade down to shorter-horizon planning.
A central premise of the annual cycle is that certain decisions must precede others. Long-range volume forecasts must be completed before headcount models can be built; headcount models must be finalized before budget submissions are made; approved budgets must be in place before hiring plans can be authorized. Violating this sequence — for instance, submitting headcount budgets before volume forecasts are stable — produces compounding inaccuracies that can persist for the entire fiscal year.
The planning calendar also establishes the cadence for major governance checkpoints: executive reviews of staffing assumptions, sign-off milestones for hiring plans, and freeze dates after which changes require formal escalation. These checkpoints are documented in advance to prevent ad hoc decision-making that undermines forecast integrity.
Key Events in the Annual WFM Calendar
Long-Range Forecasting Window
Long-range forecasting typically begins 9–12 months before the start of the planning year. During this window, the workforce management team collaborates with marketing, finance, and product teams to assemble multi-year volume projections. Inputs include historical contact volume trends, planned product launches, geographic expansion plans, and macroeconomic assumptions. The output is a monthly volume forecast that drives all downstream headcount and capacity calculations.
At this stage, forecast granularity is deliberately low — weekly or monthly intervals are sufficient because the primary purpose is budget-level accuracy, not operational scheduling. Refinements occur in later windows as the planning year approaches.
Budget Submission and Headcount Lock
Most organizations operate on an annual budget cycle tied to the fiscal year. WFM teams must deliver headcount requests — expressed as full-time equivalents — to finance by a fixed submission deadline, typically 60–90 days before fiscal year start. The headcount model at this stage incorporates the long-range volume forecast, projected Average Handle Time (AHT), target Service Level thresholds, and expected Shrinkage rates.
Budget submission is a high-stakes event because approved headcount becomes the binding constraint for hiring throughout the year. Under-requesting headcount leads to understaffing; over-requesting triggers budget cuts that reduce operational flexibility. Many organizations build contingency assumptions (typically 3–7% buffer) into headcount models to absorb forecast error.
After finance approves the budget, the headcount figure is locked for the year. Subsequent changes require a formal reforecast process, which is itself scheduled as a quarterly event on the planning calendar.
Annual Schedule Bid Period
The annual schedule bid is the process by which agents select or are assigned work schedules for the coming year, typically conducted 6–10 weeks before the new schedule year begins. Bid processes vary in form — pure seniority-based bidding, preference-matching algorithms, or hybrid models — but all require that the WFM team publish the available schedule templates in advance, collect agent preferences, and produce compliant assignments within a defined window.
The bid period has significant downstream dependencies: agent schedules affect Shrinkage planning (since scheduled training and coaching must fit around fixed shift patterns), recruiting timelines (since new hires may need to be onboarded to specific shift needs), and Adherence and Conformance measurement baselines. A delayed or poorly executed bid creates ripple effects across all subsequent planning activities.
Holiday and Peak-Period Planning
Holiday planning is a discrete planning event, typically completed 8–16 weeks before each peak period, that produces staffing plans for days when volume, Average Handle Time, and agent availability deviate significantly from baseline. For retail-adjacent contact centers, this encompasses the November–January holiday surge; for healthcare, it may include open enrollment periods; for utilities, it often corresponds to billing cycles and weather events.
Peak-period plans include elevated staffing targets, modified shrinkage assumptions (since training and non-productive time are typically reduced), overtime authorization levels, and contingency protocols for volume spikes that exceed planned capacity. These plans require coordination with HR (for approval of extended hours), operations (for site readiness), and technology (for system capacity).
Quarterly Reforecast Events
Because annual forecasts inevitably diverge from realized volume as the year progresses, most planning calendars include quarterly reforecast events — formal reviews at which WFM, finance, and operations examine year-to-date actuals against plan, update the remaining-year forecast, and request headcount adjustments if needed. The reforecast event is distinct from regular forecast updates: it is a governance checkpoint that may result in approved changes to hiring authorizations, attrition assumptions, or budget allocations.
Maturity Model Considerations
Within the WFM Labs Maturity Model, sophistication in annual planning calendar management corresponds to organizational maturity levels 2 through 4.
At Level 2, organizations maintain a basic planning calendar but execution is inconsistent — deadlines are missed, forecast inputs arrive late from business partners, and the budget submission is based on prior-year headcount rather than workload-derived models.
At Level 3, the planning calendar is formally documented and owned by a named WFM leader. Major milestones are tracked, business partners have defined input deadlines, and the long-range forecast is built from volume assumptions rather than headcount assumptions.
At Level 4, the planning calendar is integrated with enterprise resource planning (ERP) systems and financial planning tools. Reforecast events trigger automated updates to downstream models, and variance analysis from prior planning cycles is used to improve future forecast accuracy. Driver-based budgeting, in which headcount budgets are derived from workload equations rather than fixed targets, is standard practice at this level.
Related Concepts
- WFM Processes
- Capacity Planning Methods
- Shrinkage
- Workforce Cost Modeling
- Forecast Accuracy Metrics
- Service Level
- Average Handle Time
- WFM Goals
- WFM Assessment
- WFM KPI Hierarchy and Reporting Cadence
- Changes to the Future of Workforce Management
