The Maturity Model as a Transformation Framework

The Maturity Model as a Transformation Framework describes how to use the WFM Labs Maturity Model™ to run a workforce transformation, as distinct from what the model's five levels contain. The levels themselves are described in full on the model's page, and in condensed form at The Maturity Curve; this page covers the operating questions a leadership team faces once it has placed itself on the curve — where organizations actually sit, in what order capabilities are built, what each level unlocks, and how each level generates the evidence that funds the next. The underlying claim is that a maturity model's value is not classification but sequencing: knowing you are at Level 2 is worth little; knowing what Level 2 has already paid for, and what it cannot buy at any price, is the start of a transformation plan. It is part of the Adaptive Concepts series.
Where organizations actually sit

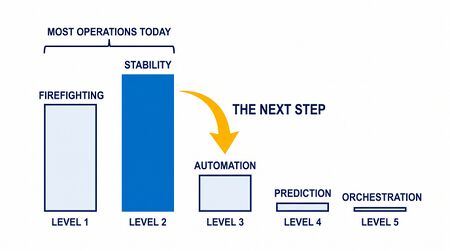

Workforce management maturity does not spread evenly across the five levels — it clusters. As of the model's publication, its authors estimated that roughly 85% of contact-center operations run at Level 1 or Level 2, with the split determined largely by scale and investment capacity.[1] Smaller operations remain at Level 1 because they have not reached the scale that justifies formal WFM software, while the industry's center of mass sits at Level 2 — a WFM platform installed, dedicated forecasting, scheduling, and real-time roles, and the legacy process pattern those platforms encode: build a detailed plan, pre-schedule development activity, react manually when reality deviates.
The clustering has a structural cause, not a talent cause. A mature vendor ecosystem spent two decades optimizing for exactly the Level 2 pattern — static planning plus reactive management — so an organization can buy its way to Level 2 and then find that the market sells very little that takes it further by itself. Level 3 is rarer because it demands rethinking the plan-defend-react habits even though it still operates inside the deterministic planning paradigm; Levels 4 and 5 are rarer still because they cross the model's phase transition, where the paradigm itself is replaced.
The phase transition
The four transitions are not equal, and treating them as equal steps is the most common planning error the model exists to prevent. The boundary between Levels 3 and 4 is a phase transition, not a step: below it, tooling amplifies an existing process — Level 3's automation executes the same corrective moves the Level 2 operation made manually, faster and more consistently; above it, the process is redesigned around what the tooling makes possible — point forecasts give way to probability bands, annual plans to continuous refresh, and single-number staffing asks to priced risk postures (see The Maturity Curve). Organizations do not drift across this boundary by getting more precise. Crossing it is a decision — new roles, new planning artifacts, new conversations with finance — and a transformation program that budgets the 3→4 transition like the 1→2 transition has mispriced it badly.
What each transition unlocks
Each transition buys a different kind of value, and mistaking which kind is being purchased is a recurring source of disappointed business cases. The right column is the one to read first — what a level cannot buy is the non-obvious half:
| Transition | What it cannot buy | What it unlocks |
|---|---|---|
| Level 1 → 2 | Adaptability — the plan is precise but static | Operational stability: predictable schedules, visible targets, a professional function |
| Level 2 → 3 | Strategic foresight — the operation adapts in-day but still plans deterministically | Automation and adaptive resilience: variance handled at machine speed, development protected |
| Level 3 → 4 (the phase transition) | Its own prerequisites — the redesign consumes telemetry, literacy, and trust built below | Strategic planning capability: staffing as probability bands, scenarios priced, planning continuous |
| Level 4 → 5 | A steady state — the orchestration layer's advantage decays as the estate it learned on changes, so the level must keep relearning | Enterprise orchestration: human–AI allocation by evidence, the operation as a learning system |
The continuity threads
Two institutions run through the whole progression without being rebuilt, and they mark the model as capability-deepening rather than replacement. The Resource Optimization Center passes through three roles: stood up at Level 2 as a coordination function, it acquires ownership of the automation rulebook at Level 3, and its natural Level 4 extension — implied rather than prescribed by the model — is execution within the probabilistic bands the planning layer publishes. The measurement system evolves in parallel, and carries the model's sharpest warning: the Level 2 trio — forecast accuracy, schedule adherence, service-level attainment — left in place as the definition of success, incentivizes defending a static plan rather than building adaptive capacity, which is how organizations become excellent at Level 2 and stuck there. At Level 3 the trio is joined by stability and automation metrics — service-level stability, automation acceptance rate, variance-capture efficiency — and reframed at Level 4 as hit-rates against chosen confidence bands rather than attainment of single-point targets. This yields a practical self-location test: an organization sits at the level whose metric vocabulary its operational reviews actually speak, regardless of what its technology inventory says.
Progression is guarded, not staged
Classic staged maturity models, in the lineage of the Capability Maturity Model, treat levels as strict prerequisites,[2] and CMMI's continuous representation later relaxed exactly that constraint for software process;[3] the WFM Labs model takes the continuous side of that argument for workforce operations. The levels are guardrails, not gates — but reordering and skipping are different things, and the test that separates them is the input test: a capability may be built early if every input it consumes already exists; it is being skipped-to if one of its inputs has to be assumed. Deploying Level 3 automation before Level 2 process discipline is complete can pass the test — automation enforcing guardrails that are published, if not yet habitual, can create the quick wins that fund the slower structural work. Deploying Level 4 probabilistic planning without Level 3 telemetry cannot: the distributions would have to be assumed, which is Level 2 planning wearing Level 4 notation.
Which capability to build first is a situational call, not a model output — the stage diagnostics in Framework Selection for Workforce Transformation are the natural instrument. And because most estates are uneven — The Maturity Curve makes honest placement a range rather than a point, with Level 3 automation in one function while measurement discipline sits at Level 2 elsewhere — sequencing is done per function, not per enterprise. Place each unit; advance each against its own binding constraint; and hold the portfolio together on a shared measurement spine, so progress stays comparable and resources can move to where the next transition is cheapest.
The evidence chain: each level funds the next
Run in order, the model is designed to be self-justifying — each level produces the data that makes the case for the one above it:
- Level 1 quantifies manual chaos. The interval variance log and posted instruments that stabilize a Level 1 operation are also its platform business case: named failure modes, counted red intervals, and hours of manual effort, priced against the operation's own data.
- Level 2 quantifies its own ceiling. A Level 2 Resource Optimization Center that logs every manual intervention, its delay, and its cost (time-to-stabilize, development sessions sacrificed) is building, interval by interval, the case for Level 3 automation — measured on the organization's own operation rather than a vendor's reference customer.
- Level 3 generates the training data for Level 4. The signals-to-actions-to-outcomes telemetry that automation produces is precisely the dataset probabilistic planning needs to model distributions instead of assuming them.
- Level 4 makes plans machine-consumable for Level 5. Once plans are expressed as published ranges with explicit constraints and triggers, an orchestration layer can execute against them; a deterministic annual plan has no interface an autonomous system can consume.
The practical corollary: an organization that cannot articulate the business case for its next level usually has an instrumentation gap at its current one — the case exists, but nothing is recording it.
Position in the series
Within the Adaptive Concepts series this page is the hinge between diagnosis and operation: the pages before it diagnose the environment and select the frameworks, the five level pages that follow — beginning with Level 1: The Excel Foundation and Level 2: Structured Workforce Management — describe operating at each level, and the sequencing rules here (phase-transition pricing, the input test, per-function placement) are what convert a placement on The Maturity Curve into a program.
See Also
- WFM Labs Maturity Model™ — the five levels in full
- The Maturity Curve — the condensed view and the phase transition
- Adaptive Concepts — the series this page belongs to
- Variance Harvesting — the Level 3 operating principle
- Workforce Management Governance and Change Management — sustaining progression
References
- ↑ Adaptive (WFM Labs, 2026), ch. 6. A practitioner estimate at time of publication, drawn from implementation experience rather than survey data.
- ↑ Paulk, M. C., Curtis, B., Chrissis, M. B., & Weber, C. V. (1993). Capability Maturity Model, version 1.1. IEEE Software, 10(4), 18–27.
- ↑ CMMI Product Team (2002). Capability Maturity Model Integration, Version 1.1 (continuous representation). Software Engineering Institute, Carnegie Mellon University.
