Theory of Constraints in Workforce Planning
Theory of Constraints in Workforce Planning applies Eliyahu M. Goldratt's Theory of Constraints (TOC) — first articulated in The Goal (1984) — to workforce management. TOC's central claim is deceptively simple: every system has exactly one constraint that limits its throughput. Improving anything other than the constraint is waste. This is a radical reframing for WFM organizations accustomed to improving everything simultaneously.
In a workforce system, the constraint is usually the scarcest skill group, the tightest interval, or the queue with the highest impact on revenue. TOC provides a disciplined methodology for identifying that constraint, exploiting it fully, subordinating everything else to it, and elevating it only after the first three steps are exhausted. Applied correctly, TOC prevents the most common WFM resource allocation error: spreading investment evenly across all queues when only one is limiting system performance.
Overview
Goldratt's insight came from manufacturing: a production line moves only as fast as its slowest machine. Adding capacity to any non-bottleneck machine increases work-in-process inventory but not throughput. The same physics apply to service operations. A contact center with five skill groups moves at the pace of its most constrained group — and "adding staff to a non-bottleneck queue wastes money" is the WFM equivalent of Goldratt's factory floor observation.
The relevance extends beyond staffing. WFM operates multiple process chains: forecasting feeds scheduling feeds real-time management feeds reporting. If the scheduling process is the bottleneck (schedules published late, preventing real-time optimization), improving the forecasting process adds accuracy that the downstream constraint cannot exploit. TOC forces WFM leaders to ask: what is actually limiting our system's throughput?

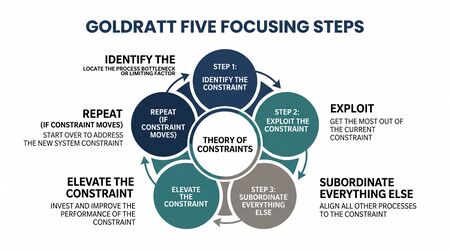

The Five Focusing Steps
Step 1: Identify the Constraint
In WFM, the constraint takes one of four forms:
Skill constraint: The queue or skill group with the greatest gap between demand and supply. A center with adequate general customer service agents but a chronic shortage of bilingual technical support agents is constrained by bilingual tech support. Every abandoned call in that queue is system throughput lost.
Interval constraint: The time period with the worst staffing ratio. Monday morning 8:00–10:00 AM is the constraint for many operations — highest demand, lowest agent availability (late arrivals, PTO patterns). The interval constraint limits the system's ability to maintain consistent service.
Process constraint: The WFM process that bottlenecks operational effectiveness. Scheduling published only 2 weeks ahead prevents agents from planning their lives, drives attrition, and limits overtime management flexibility. The scheduling process — not staffing — is the constraint.
Policy constraint: An organizational rule that prevents optimal resource deployment. "Agents cannot work more than one queue" is a policy constraint that prevents the pooling effect. "Overtime must be approved by VP" is a policy constraint that prevents timely capacity adjustment.
How to identify: The constraint is where work piles up (calls queue), where service degrades first (interval with worst service level), or where the system hits its limit (the skill group that runs out of capacity first during a demand spike). Mathematically: the constraint is the resource with the highest utilization rate — it saturates before anything else.
Step 2: Exploit the Constraint
Before adding capacity, extract maximum throughput from the existing constraint. This is the highest-ROI step because it costs almost nothing.
For a skill constraint:
- Ensure constrained agents spend zero time on work that non-constrained agents could do. If a bilingual tech agent is handling monolingual billing calls, that is constraint waste.
- Reduce shrinkage for the constrained group. Every training session, meeting, or coaching session that pulls a constrained agent off the queue costs more than the same activity for a non-constrained agent.
- Extend the constrained agents' shift coverage. Offer premium overtime (at higher-than-standard rates) specifically to the constrained skill group — the incremental throughput is worth the premium.
- Optimize AHT for the constrained queue. Desktop tools, knowledge base improvements, and AI copilot assist targeted at the constrained skill group have outsized system impact.
For an interval constraint:
- Maximize agent availability in the constrained interval. Shift start times, break placement, meeting schedules, and training blocks should all be designed to maximize coverage during the constraint.
- Reduce in-interval shrinkage. No coaching, no team meetings, no discretionary activity during the constrained intervals.
- Deploy every multi-skilled agent to the constrained queue during constrained intervals, even if their "home" queue suffers marginally.
For a process constraint:
- Eliminate waste in the bottleneck process. If scheduling is the constraint, every manual step, approval delay, and data-gathering cycle in the scheduling process is a candidate for elimination.
- Dedicate the best resources to the constraint. The most skilled WFM analyst should work the constrained process, not the easiest one.
Step 3: Subordinate Everything to the Constraint
Non-constraint resources adjust their behavior to support the constraint. This is the culturally hardest step because it requires accepting sub-optimal performance in non-constrained areas.
Examples:
- Non-constrained queues accept higher occupancy (meaning slightly worse service levels) so that shared resources (supervisors, QA evaluators, technology support) are available for the constrained queue.
- Training schedules for non-constrained agents are flexed to free up training room time for constrained-skill development.
- Recruiter effort concentrates on the constrained skill group, even if non-constrained positions also have openings.
- The WFM team spends more analytical time on the constrained queue's forecast accuracy, schedule optimization, and real-time management than on non-constrained queues.
The subordination test: If a proposed action improves a non-constrained area but does not help the constraint, it should be deprioritized. If it improves a non-constrained area at the expense of the constraint, it should be rejected.
Step 4: Elevate the Constraint
If exploitation and subordination are insufficient, invest to expand the constraint's capacity:
- Hire more agents for the constrained skill group
- Cross-train agents from non-constrained groups (see Learning and Development Impact on WFM)
- Engage BPO or temporary staffing for the constrained skill
- Deploy automation or AI to handle a portion of the constrained queue's volume
- Change the process that creates the constraint (e.g., redesign the customer journey to reduce demand on the constrained queue)
Elevation costs money. Do it only after Steps 2 and 3 are exhausted — because exploitation and subordination are essentially free.
Step 5: Repeat (Don't Let Inertia Become the Constraint)
When the constraint is elevated sufficiently, it is no longer the constraint — something else becomes the bottleneck. Return to Step 1 and identify the new constraint.
The inertia warning: Organizations build policies, processes, and culture around the old constraint. When the constraint moves, those artifacts remain and become policy constraints — rules that made sense for the old bottleneck but now limit the new system. Annual shift-bidding seniority rules designed when night coverage was the constraint may persist long after the real constraint has moved to a specialized skill group.
Drum-Buffer-Rope for Workforce Scheduling
Drum-Buffer-Rope (DBR) is Goldratt's scheduling methodology for production systems. It translates directly to workforce scheduling.
The Drum
The drum is the constraint — it sets the pace for the entire system. In WFM terms: the constrained queue's capacity determines the system's throughput. The schedule must be built around the constraint first.
Practical application: Schedule the constrained skill group first. Lock their shifts, breaks, and activity assignments before scheduling anyone else. Non-constrained schedules then fill around the drum's rhythm.
Most WFM tools schedule simultaneously across all queues. TOC-informed scheduling inverts the priority: the constrained queue's schedule is the master schedule, and all other schedules are subordinate. This may require manual intervention after the optimizer runs — moving agents to the constrained queue during its peak intervals, even if the optimizer allocated them elsewhere based on a weighted-average objective.
The Buffer
The buffer protects the constraint from disruption. In manufacturing, it is inventory placed in front of the bottleneck machine so it never starves for input. In WFM, it is excess coverage capacity positioned around the constraint.
Time buffer: Over-staff the constrained queue by 5–10% during the interval immediately preceding and following the constraint's peak. This absorbs late arrivals, early departures, and unplanned absences that would otherwise leave the constraint under-covered.
Skill buffer: Cross-trained agents who can be deployed to the constrained queue on short notice. These agents work their home queue by default but are pre-authorized and pre-rostered to switch when the constrained queue degrades.
Schedule buffer: Unassigned "swing" agents in the schedule who can be deployed in real-time to whichever queue hits constraint conditions. This is the real-time management equivalent of a safety stock.
The Rope
The rope limits the release of work into the system to match the constraint's capacity. In manufacturing, it prevents over-production upstream of the bottleneck. In WFM:
- Inflow control: IVR routing rules that throttle demand into the constrained queue during peak periods — offering callback, routing to self-service, or diverting to lower-priority queues.
- Workforce release control: Agents scheduled for non-constrained work are not released to overtime or VTO if the constraint needs their capacity.
- Training admission control: New hire class sizes are calibrated to the constrained skill's hiring need, not to the non-constrained pipeline.
Throughput Accounting for WFM Decisions
Goldratt proposed throughput accounting as an alternative to traditional cost accounting. The framework has three measures:
| Measure | Definition | WFM Translation |
|---|---|---|
| Throughput (T) | Revenue generated per unit of time | Revenue-generating contacts handled per hour (for sales/retention) or service level maintained per hour (for service queues) |
| Investment (I) | Money tied up in the system | WFM technology, training pipeline inventory (agents in training), scheduling infrastructure |
| Operating Expense (OE) | Money spent to turn investment into throughput | Labor cost, technology licensing, facility cost, management overhead |
Decision rule: A good decision increases T and/or decreases I and/or decreases OE. If forced to choose, prioritize T over OE. Increasing throughput by $100K is better than reducing cost by $100K because throughput has no upper bound while cost reduction hits a floor.
WFM application: Traditional WFM optimizes cost (OE) — minimize labor expense at target service level. TOC-informed WFM optimizes throughput first: maximize the number of high-value interactions the constraint can process, then minimize the cost of everything else.
Example: A retention queue (the constraint) handles calls worth $480 CLV each. Adding one agent to this queue processes 8 additional calls/hour × 8 hours = 64 calls/day × 260 days = 16,640 calls/year. At 35% save rate and $480 CLV: throughput gain = 16,640 × 0.35 × $480 = $2,795,520. Agent cost: $79,000. The throughput-to-cost ratio is 35:1. No cost reduction elsewhere in the operation comes close.
The Evaporating Cloud for WFM Trade-offs
The Evaporating Cloud (Conflict Resolution Diagram) is TOC's tool for resolving trade-offs that appear to be zero-sum. Format:
Objective: [What we both want]
Requirement A: [Need 1] Requirement B: [Need 2]
Prerequisite a: [Action 1] Prerequisite b: [Action 2]
CONFLICT
WFM example — Service Level vs. Cost:
Objective: Deliver profitable customer service
Requirement A: Meet service level targets
Prerequisite a: Staff to meet demand at 80/20
Requirement B: Control labor cost
Prerequisite b: Minimize headcount
CONFLICT: a and b oppose each other
The evaporating cloud resolves by challenging the assumptions underlying the prerequisites:
- Assumption behind (a): "The only way to meet 80/20 is more agents." Challenge: automation, skill-based routing, schedule optimization, and AHT reduction also improve service level without adding headcount.
- Assumption behind (b): "Minimizing headcount minimizes cost." Challenge: understaffing drives overtime, attrition, and customer churn that may exceed the headcount savings. See Financial Impact Modeling for WFM Decisions.
The cloud "evaporates" when a solution addresses both requirements by invalidating an assumption. Example solution: invest in AI containment that handles 20% of volume, maintaining service level while reducing required headcount. The conflict dissolves — both requirements are met.
This connects directly to Multi-Objective Optimization, which provides the mathematical framework for navigating the same trade-offs that the evaporating cloud resolves conceptually.
Worked Example: TOC Applied to a Multi-Queue Center
Scenario: 5 queues, 300 total agents, chronic service level failures.
| Queue | Agents | Required | Utilization | SL Actual | SL Target |
|---|---|---|---|---|---|
| General service | 120 | 115 | 78% | 84/20 | 80/20 |
| Billing | 80 | 75 | 76% | 82/20 | 80/20 |
| Technical support | 50 | 55 | 94% | 62/20 | 80/20 |
| Retention | 30 | 35 | 96% | 58/20 | 80/20 |
| Sales | 20 | 18 | 72% | 88/20 | 80/20 |
Step 1 — Identify: Retention (96% utilization, 58/20 SL) and Technical Support (94%, 62/20) are the constraints. Retention has the highest throughput value (revenue retention) — it is the primary constraint.
Step 2 — Exploit:
- Audit retention agent shrinkage: currently 38%. Reduce to 33% by rescheduling meetings outside peak hours and deferring non-critical training. Gains 2.5 effective FTEs.
- Optimize retention call routing: pre-qualify callers in IVR, reducing AHT from 14.2 to 12.8 minutes. Equivalent to 3 additional agents in throughput.
- Result: effective retention capacity rises from 30 to ~35.5 FTEs. SL improves to 78/20.
Step 3 — Subordinate:
- Cross-trained billing agents (15 qualified in retention) are pre-assigned to retention overflow during peak intervals. Billing SL drops from 82/20 to 79/20 — acceptable.
- Sales agents (over-staffed) provide general service backup, freeing general service resources to train on retention.
- WFM analyst time shifts from sales forecasting refinement (already over-staffed) to retention demand analysis.
Step 4 — Elevate: If steps 2–3 are insufficient:
- Hire 5 retention agents (pipeline: 12 weeks)
- Cross-train 10 technical support agents on basic retention scenarios (pipeline: 4 weeks)
- Deploy AI assist for retention agents (reduce AHT by an additional 1 minute)
Step 5 — Repeat: After retention reaches 80/20, technical support becomes the constraint. Repeat the cycle.
Maturity Model Position
| Maturity Level | TOC Application | Characteristics |
|---|---|---|
| Level 1 — Ad Hoc | No constraint awareness | Resources spread evenly. "Improve everything" mentality. Whack-a-mole management. |
| Level 2 — Emerging | Bottleneck identification | Worst-performing queue gets attention. No systematic exploitation or subordination. |
| Level 3 — Established | Five Focusing Steps applied | Formal constraint identification. Exploitation before elevation. Cross-queue subordination. |
| Level 4 — Advanced | DBR scheduling + throughput accounting | Scheduling prioritized by constraint. Investment decisions use throughput math. |
| Level 5 — Optimized | Dynamic constraint management | Real-time constraint identification (shifts across intervals/days). Automated resource reallocation. |
See Also
- Multi-Objective Optimization — Mathematical framework for the trade-offs TOC addresses conceptually
- Lean Principles Applied to Workforce Management — Complementary operations theory (waste elimination) applied to WFM
- Variability and Resilience in Workforce Systems — Buffer strategies connect to TOC's buffer concept
- Financial Impact Modeling for WFM Decisions — Throughput accounting and investment ROI calculations
- Real-Time Operations — Where constraint management plays out in real-time decisions
- Erlang C — Utilization calculations that identify the mathematical constraint
- Unit Economics of Workforce Operations — Throughput-per-unit metrics for TOC analysis
References
Cite error: <ref> tag with name "goldratt1984" defined in <references> is not used in prior text.
Cite error: <ref> tag with name "goldratt1997" defined in <references> is not used in prior text.
Cite error: <ref> tag with name "dettmer2007" defined in <references> is not used in prior text.
Cite error: <ref> tag with name "schragenheim2009" defined in <references> is not used in prior text.
