Integrated Global Resource Optimization Center

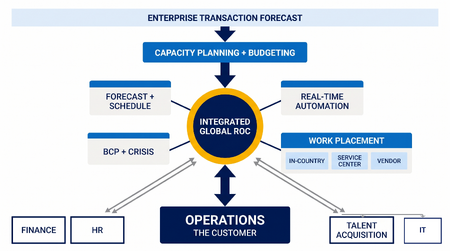

Integrated Global Resource Optimization Center (global ROC) is an operating model that extends the traditional resource optimization center — the consolidated real-time command room — into a single coordination point for the full workforce ecosystem. In the conventional model, workforce management produces forecasts and schedules and then steers the day against them — balancing supply and demand within a fixed distribution of work. The integrated model adds a second, standing function: placement. The workforce function does not merely staff the work where it happens to sit; it continuously decides where work should sit — across in-country teams, captive global service centers, and outsourced vendors — using the same machinery at every horizon, from strategic sourcing to the routing of a single deferred task. Placement is the defining addition; the remaining functions are the inherited core, re-based on the shared picture placement requires. The global ROC is thus both a control room and a placement engine — and its customer is operations: every product of the center exists to make an operations leader's next decision better.
From command center to placement engine
The traditional ROC is the mature form of Real-Time Operations: one room, one set of operating standards, one owner of the number at any moment of the day.[1] Its scope, however, inherits a boundary from the history of the discipline — it manages the workforce given the distribution of work, while the distribution itself is decided elsewhere: sourcing decisions in procurement or vendor management, continuity decisions in a separate business-continuity function, hiring decisions in a budget cycle.
The integrated model dissolves that boundary on a specific argument: placement, staffing, and intraday steering are the same optimization at different horizons. Where does capacity get built; where does this client's work sit; where does this task go right now — the same question, answered by the same constraint logic, differing only in which constraints bind (see Capacity Planning Cycle and The Workforce Broker). Splitting these across organizational silos means each silo optimizes its slice against a picture the others cannot see.
The four integrated functions
- Forecasting and scheduling. The inherited core. Requirements and rosters continue to be produced, but against driver-based demand from the enterprise forecast and against a supply picture spanning every node type — the schedule inherits placement decisions instead of assuming the current distribution of work.
- Real-time automation. Intraday variance acted on by machine within governed bounds: schedule adjustment, skill re-assignment, surplus-time harvesting. The room supervises automation rather than performing every adjustment by hand.
- Work placement. The function conventionally fragmented under labels like outsourcing management or BPO governance, operated instead as a continuous discipline: deficits cleared against surpluses before requisitions open, work floated to vendors only against named justifications, and the depth trajectory of every pool managed deliberately (see Speed to proficiency curve). Placement spans all three node types — in-country, global service center, and vendor — under one quality instrument (see BPO and Vendor Management for WFM). The evidence base supports this consolidation: back-office quality tracks process codifiability and governance design rather than ownership,[2] and in panel data, the customer-satisfaction penalty of outsourcing attaches to the outsourcing boundary itself, with no distinct offshore effect.[3]
- Continuity and crisis. Business continuity planning is placement under duress: a site outage, a weather event, or a correlated demand surge is a sudden change in the constraint set, answered by re-deriving placement, not by executing a static binder. Housing continuity inside the center means the crisis response uses the same live picture of capacity, capability, and constraint as the daily operation — and gets exercised monthly instead of annually.
The interconnections
The center has one customer, one upstream feed, and a set of lateral interlocks:
- Operations — the customer. The strongest connection in the model, and the reason the center exists. Every product the center makes — the forward surplus/deficit view, the placement proposal with its named constraints, the intraday steer, the crisis re-plan — is delivered to operations leaders, who own the outcomes and hold the decision rights at commitment points. The other interfaces exist so that this one works: a center that serves finance's calendar or its own dashboards before the operation it steers has inverted its purpose.
- Enterprise transaction forecasting → capacity planning and budgeting (upstream). Demand enters as business drivers — transactions, bookings, client wins and losses — flowing from the enterprise forecast into capacity planning and budgeting, which feeds the center as its standing demand contract. The workforce forecast becomes a consumer and refiner of the enterprise number, and the budget becomes a living derivative of the same figure, replacing separately maintained estimates (see the demand refresh stage of the Capacity Planning Cycle).
- Finance. Every placement decision carries a cost consequence — the price of a move versus a hire, the carrying cost of surplus, the premium paid for flexible capacity. The center prices decisions as it makes them, and reconciliation with the financial plan is a standing interface, not a periodic exercise.
- Human resources. Employment frameworks set which moves are feasible at what speed — notice periods, consultation obligations, cross-border employment vehicles. The center carries these as explicit entries in the constraint registry, so a placement proposal arrives already tested against policy instead of failing on it after commitment.
- Talent acquisition. Residual hiring need — what survives the clearing of deficits against surpluses — flows to recruiting as requisitions with need-by dates back-computed from source, train, and ramp lead times. Recruiting capacity and class scheduling flow back as supply constraints.
- The capability record. All of it presupposes one trusted record of who can do what — skills, languages, licenses, permissions — spanning humans and automated agents alike (see Workforce Planning with AI Agents). The placement engine is only as good as the capability substrate beneath it.
What changes organizationally
The consolidation does not centralize every decision; it centralizes the picture and the machinery. Operations leaders still own their outcomes, vendor managers still own contracts and commercial enforcement, and continuity owners still own preparedness standards. What moves is the standing computation — one view of demand, capacity, capability, and constraint, computed continuously, from which each owner draws decisions. Where these functions optimize separately, their pictures of demand and capacity diverge, and the divergence surfaces only under stress: a surge, a client loss, an audit.
The model earns its overhead at scale and complexity: multiple books of work, more than one node type, and demand volatile enough that placement genuinely moves. A single-site operation with one book gets the same discipline from the Capacity Planning Cycle alone; the integrated center is the form that discipline takes when the estate is large enough that no single function can hold the picture.
Maturity Model Position
- Levels 1–2: no integrated center exists; real-time steering, sourcing governance, and continuity live in separate functions with separate data.
- Level 3: a consolidated command room operates across books of work with real-time automation; placement remains a periodic, meeting-driven exercise.
- Level 4: placement runs as a standing function inside the center on shared definitions and a capability record; continuity is exercised through the same machinery; finance and talent acquisition interfaces are live, not cyclical.
- Level 5: the placement computation is continuous, with human governance at the commitment points — the moments where a decision becomes a contract, a requisition, or a client promise; enterprise forecast, capability record, and constraint registry update the picture without manual assembly (see WFM Labs Maturity Model™).
See Also
- Real-Time Operations — the command-center foundation this model extends
- Capacity Planning Cycle — the monthly operating cycle the center runs
- The Workforce Broker — the clearing and fungibility doctrine behind placement
- Business Process Outsourcing — the engagement models placement spans
- BPO and Vendor Management for WFM — vendor governance under one quality instrument
- Workforce Planning with AI Agents — the capability record substrate
- Supply Elasticity in Workforce Planning — why placement, not prediction, moves outcomes
- Interconnected Workforce Management — the full interface register the centre's interconnections belong to
- ROC Organization Models — the four shapes and the two-layer hybrid
- Role Evolution in the Resource Optimization Center — what happens to the vendor, continuity and crisis roles when they move into the centre
References
- ↑ Cleveland, B. (2012). Call Center Management on Fast Forward (4th ed.). ICMI Press.
- ↑ Liu, Y., & Aron, R. (2015). Organizational control, incentive contracts, and knowledge transfer in offshore business process outsourcing. Information Systems Research, 26(1), 81–99.
- ↑ Whitaker, J., Krishnan, M. S., Fornell, C., & Morgeson, F. V. (2019). How does customer service offshoring impact customer satisfaction? Journal of Computer Information Systems.
